(+977) 1 570 5916 , (+977) 1 570 5148 (+977) 1 570 5057
  pidmail@kuklpid.org.np
 TankaPrasad Ghumti Sadak

Government of Nepal
Melamchi Sub-Project 2

Kathmandu Upatyaka Khanepani Limited
Project Implementation Directorate (PID)

Notice
Approved BES of Gokarna Sewer Network     Addendum No-1 for Bids Contract No.- KUKL/WW-/SN-04 Sewer Network Development Works in Gokarna     Final Environmental Examination Report of Improvement of Water Supply System in Gokarneswor Municipality 5-6-7 -8-9 KMC ward no 6-7 partially and Budhanilkantha ward no 11     Initial Environmental Examination Report of Improvement of Water Supply System in Gokarneswor Municipality 5-6-7 -8-9 KMC ward no 6-7 partially and Budhanilkantha ward no 11

About Us

Welcome to PID

Government of Nepal has accorded a high priority to the task of providing safe and adequate drinking water in an equitable manner to the people of Kathmandu Valley. Residents of Kathmandu valley have been suffering from the hardship caused due to lack of adequate and safe drinking water for a long time.The Government started Melamchi Water Supply Project in December 2000, to solve the chronic drinking water shortage in valley on a sustainable manner.

Melamchi Project envisages 510 MLD water to Kathmandu Valley from Melamchi, Yangri and Larke Rivers of Sindhupalchowk District. Phase 1 of the project will bring in 170 MLD by September 2017, when the 26 Km diversion tunnel from Melamchi to Sundarijal is completed.The water available from this project will be treated at Sundarijal- Water Treatment Plant (WTP) which is currently under construction. As per Government plan, the treated water will be supplied to the nine Service Reservoir Tanks (SRT), located at different places of Valley through Bulk Distribution System (BDS).These reservoirs will supply water to household via entirely new distribution system called Distribution Improvement Improvement (DNI). Initially, the Melamchi Water Supply Project was designed to implement all of these activities under the umbrella of the Melamchi Water Supply Development Board, but later in February 2008, the project was divided into Subprojects 1 & 2 for its efficient implementation.

Er. Rajendra Sapkota

Project Director

Contact Details

(+977) 1 570 5086 -

Er. Chandra Kumar Pan Shrestha

Information Officer

Contact Details

(+977) 1 570 5086 pidkukl@gmail.com

Message From Project Director

On behalf of Project Implementation Directorate (PID), Kathmandu Upatayaka Khanepani Limited (KUKL), I welcome you to our website.

The Government of Nepal is committed to providing reliable, equitable and safe drinking water and sanitation services to the residents of Kathmandu Valley. At PID, our multi-diverse professional team is working relentlessly towards completing the construction of water and sanitation infrastructure. In terms of numbers, this entails: approximately 1200 km new pipe network, 10 new water service reservoirs, 45 km new interceptors, and 5 new wastewater treatment plants in different locations in Kathmandu within 2020. This is being implemented under Kathmandu Valley Water Supply Improvement Project (KVWSIP) and Kathmandu Valley Wastewater Management Project (KVWMP) supported by Asian Development Bank.All the construction works are in full swing.

Er. Rajendra Sapkota

Project Director

New investments planned in subsequent phases will help expand infrastructure works outside Ring Road and other areas within Kathmandu Valley. Our efforts are aimed at developing water infrastructure necessary to secure safe and sufficient water for every household through a 27.5-km-long Melamchi tunnel, and ensuring that Kathmandu rivers flow cleaner and faster through treated sewerage systems by constructing wastewater treatment plants and installing sewer pipes.

As part of tests aimed at commissioning the new distribution system that will convey water once it is received through the Melamchi tunnel, flushing of Bulk Distribution System pipeline is being carried out before moving on to smaller pipes.

Despite our hard work, people in Kathmandu Valley may have to face some inconvenience during the implementation of the projects. As this is once-in-a-lifetime event, I humbly request respected fellow citizens of Kathmandu to bear with these difficulties. Through this website, we have attempted to inform and disseminate our works. Should you have any questions or feedback, we very much appreciate and look forward to hearing from you.

Thank you for your support, understanding and cooperation.

Notices

ADDENDUM No. 1 Bids No: PID-KUKL /Office Building/NCB/ 2079/80 for Construction of Administrative Building for PID, KUKL at Dhobighat, Lalitpur

Bidding Document & Drawings for Contract no PID-KUKL /Office Building/NCB/ 2079/80- Construction of Administrative Building for PID, KUKL at Dhobighat, Lalitpur

Notice of Intent to Award for Contract No.: KUKL/SRT /06B Construction of Two Service Reservoir Tanks (SRTs) at Balaju

Invitation for Bids No: PID-KUKL /Office Building/NCB/ 2079/80 for Construction of Administrative Building for PID, KUKL at Dhobighat, Lalitpur

Minutes of pre-Bid Meeting - Contract No. KUKL-SRT-06B - Construction of Two Service Reservoir Tanks (SRTs) at Balaju

Progress Report

S.No. Name of Packages Total Quantity of Work (km) Cummulative Progress Percentage (km%) Download
Km %
1 Bulk Distribution System 0 (Loan No -1820) 9.46 km 9.46 km 100% -
2 Bulk Distribution System 1 (Loan No -2776) 11.26 km 11.06 km 98.22% -
3 Bulk Distribution System 2 (Loan No -2776) 27.00 km 26.97 km 98.22% -
4 Bulk Distribution System - 3 (Loan No -2776) 15.97 km 15.08 km 96.85% -
5 Bulk Distribution System - 4 (Loan No -3225) 14.29 km 14.01 km 98.03% -
6 Laying of Transmission Main from Sundarijal to Chabahil Chowk, and Construction of Related Civil Structures (KUKL/BDS-05) 25.78 Km 0.45 km 1.74% -
Total of 1, 2, 3, 4, 5 & 6 103.76 Km 77.31 Km 74.50 %
S.No. Name of Packages Total Quantity of Work (km) Cummulative Progress Percentage (km%) Download
1 Distribution Network Improvement Works (Package -1) KUKL/DNI/01/04 Pipe Laying : 303.03 KM
HHC: 26,889
Pipe Laying 303.03 Km
HHC: 26,484
-
2 Distribution Network Improvement Works (Package -2) KUKL/DNI/01/05 Pipe Laying : 320.17 Km
HHC : 30,634
Pipe Laying 317.01 Km
H.H.C : 25,849
-
3 Distribution Network Improvement Works (Package -3) KUKL/DNI/01/06 Pipe Laying : 168.83 Km
HHC : 12,414
Pipe Laying 168.83 Km
H.H.C. :12,409
-
4 Distribution Network Improvement Works (Package -4) KUKL/DNI/01/07A Pipe Laying : 228.06 Km
HHC : 32,637
Pipe Laying 228.06 Km
HHC : 17,583
-
5 Distribution Network Improvement Works (Package -5) KUKL/DNI-9A-01 KAPAN (GoN) Pipe Laying : 160.00 Km
HHC : 8229
Pipe Laying 69.02 Km
HHC : 4036
-
6 Distribution Network Improvement Works (Package -6) KUKL/DNI/01/7B (GoN) Pipe Laying : 224.37 Km
HHC : 25,132
Pipe Laying 96.10 Km
HHC : 6721
-
7 Distribution Network Improvement Works (Package -7) KUKL/DNI/01/7C (GoN) Pipe Laying : 249.18 Km
HHC : 19,960
Pipe Laying 103.18 Km
HHC : 6865
-
8 Distribution Network Improvement Works (Package -8) KUKL/DNI/9A-Mandikhatar (GoN) Pipe Laying : 130.29 Km
HHC : 14198
Pipe Laying 35.97 Km
HHC : 400
-
Total of 1, 2, 3, 4, 5, 6, 7 & 8 Pipe Laying : 1783.93 Km
HHC : 170,093
Pipe Laying 1321.20 Km
HHC : 100,711
-
S.No. Name of Packages Capacity (MLD) / Total Quantity of work (Km) Cummulative Progress Percentage (%) Download
Wastewater Treatment Plants (WWTPs)
1 Rehabilitation and Expansion of WWTPs at Guheshwori (TP-01) 32.4 MLD 100 -
2 Construction of WWTPs at Sallaghari, Kodku and Dhobighat (TP-02) 68.7 MLD 26.81
3 Construction of WWTP at Dhobighat (TP-03) 37 MLD 71.5 -
4 Construction of DEWATS at Gokarna and Hanumanghat (DEWATS-01) 3.5 MLD 0.5 -
Interceptors/ Sewer Network Total Quantity Of Work(KM) Cummulative Progress (KM)
5 Construction of Intercepting Sewerage System along Hanumante River (IS-01) Pipe Laying : 25.33 Km 16.83 Km -
6 Extension and Construction of Intercepting Sewerage System along Manohara River (IS-02) 11.63 Km 5.82 Km
7 Construction of Sewer Collectors along Kashyang Khusung River (IS-03) 7.67 Km 7.1 Km
8 Sewer Rehabiliation in the Core City of Area of Lalitpur Municipality City (SN-03) 2.8 Km 1.14 Km
9 Baluwatar Storm water Management Works 1.23 Km 0.656 Km
S.N. Title Location Capacity Cummulative Progress Percentage (%) Download
S.N. Title Download
1 आयोजना कार्यन्वयन निर्देशनालयको आ. व. २०७६/०७७ को वार्षिक प्रगति विवरण

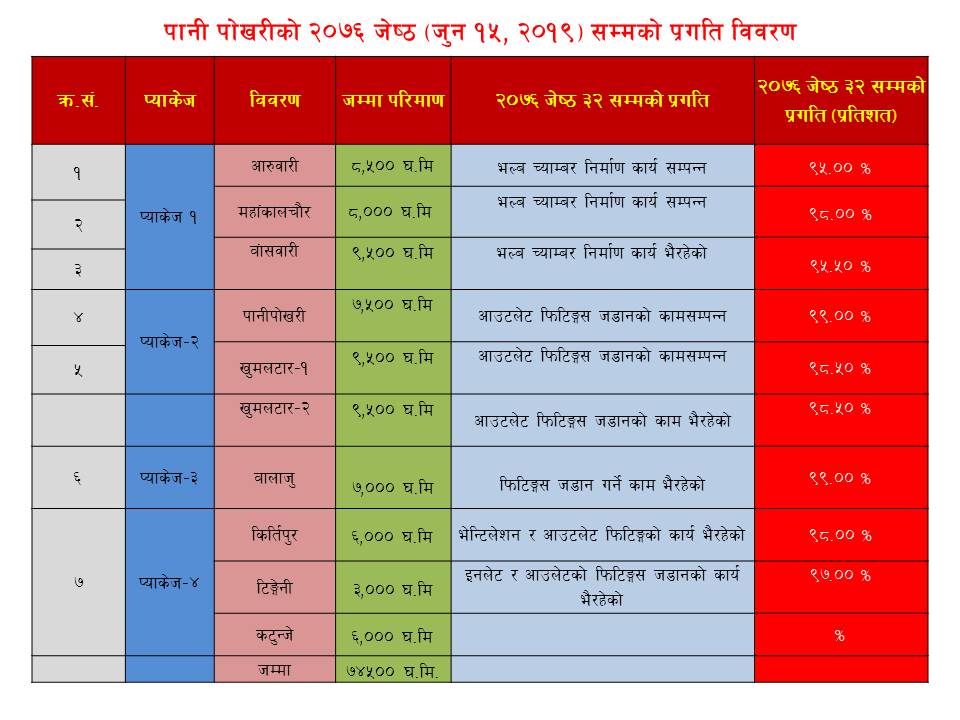

2 पानी पोखरीको २०७६ जेष्ठ (जुन १५, २०१९) सम्मको प्रगति विवरण
3 Kathmandu Valley Water Supply Improvement Project, ADB Loan No. 3255 Quarterly Progress Report (October-December, 2018).docx
4 Bi-Annual Environmental Compliance & Monitoring Report --
5 Bi-annual Progress Report of Community Awareness and Participation Consultant (CAPC)
S.N. Title Download

Events

Latest Events & News

3/1/2023
काठमाण्डौ पानी त्रैमासिक बुलेटिन वर्ष-७, अंक-१ (नेपाली) (अक्टुवर- डिसेम्बर २०२२)
3/1/2023
Kathmandu Paani Quarterly Bulletin Vol- 7 Issue-1 English (October-December 2022)
8/2/2020
Kathmandu Paani Quarterly Bulletin Vol- 5 Issue-2 Nepali ( April-June 2020)
1/21/2020
Kathmandu Paani Quarterly Bulletin Vol- 4 Issue-4 English, December 2019
2/16/2019
Press Release Jan
5/20/2018

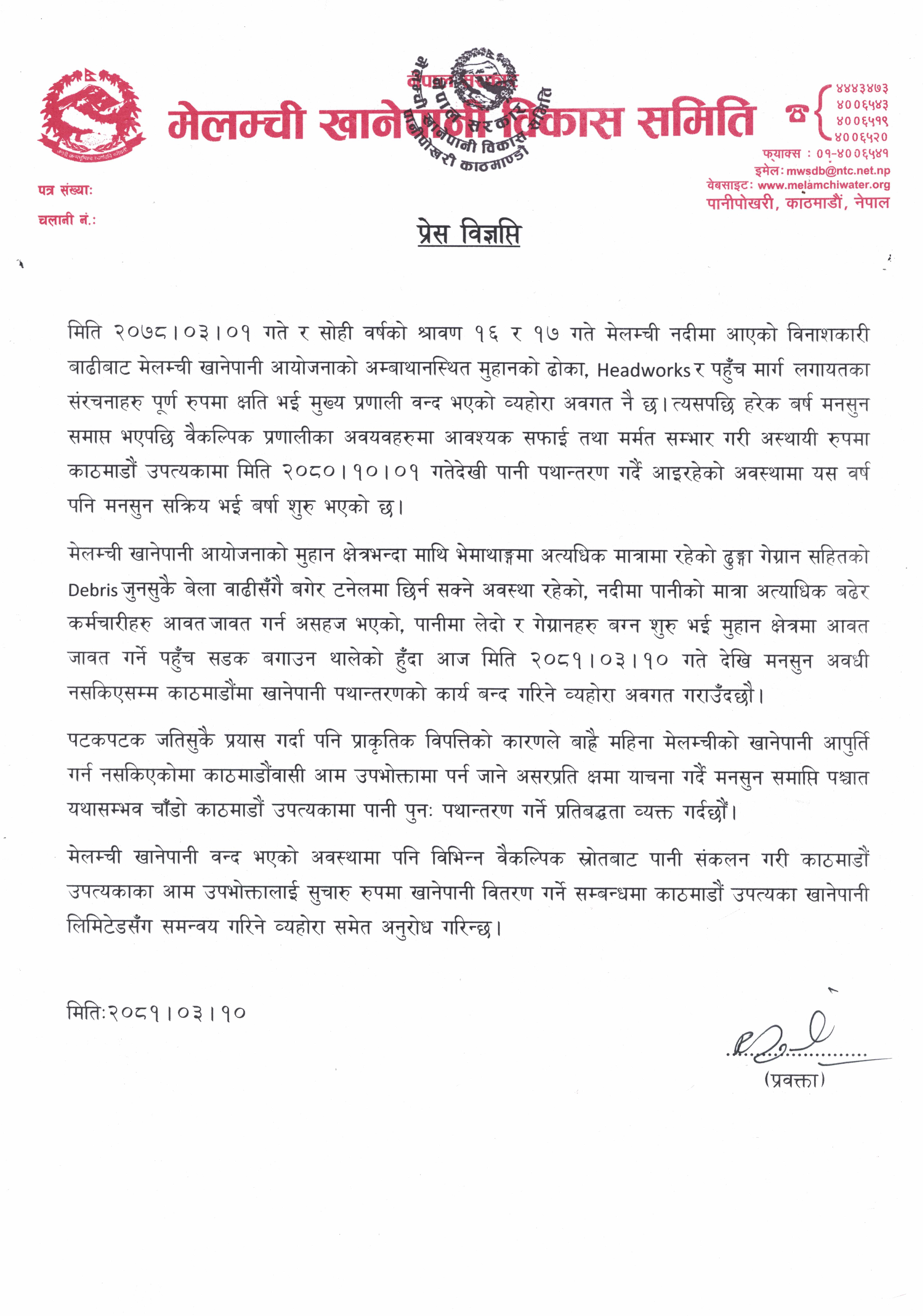

Press Release Nepali 11 july, 2017
